Question#1

Which 2 actions should the Team Leader take to implement the new Must Have requirement?

A. Consolidate and circulate an agenda for the workshop.
B. Add the additional tasks required to create the financial transaction functionality to the Timebox Plan.
C. Discuss the development interfaces and dependencies with the Solution Development Team to ensure the associated Timebox is appropriate.
D. Agree to de-scope Should Have and/or Could Have requirements to allow for the new Must Have functionality.
E. Source and hire a web developer with experience in developing online financial transaction functionality.

Question#2

Towards the end of the Foundations phase of Project Increment 4, with the high-level requirements agreed, Hira, has asked the Developers to estimate the work required to deliver the Eco spa solution.

Answer the following questions related to estimating the work involved.
The Developers have used the Planning Poker technique to generate their estimates. Hira now needs to determine how many Sprints will be required for the Delivery Teams to deliver the Eco-spa.
What should the Developers do to help Hira make this decision?

A. They should use the commitment-based planning technique to estimate how many story points of work can be achieved in a Sprint.
B. They should convert story points to person days, allowing Hira to establish how many Sprints will be needed based on development capacity.
C. They should assign average time allocations for each backlog item, making it easy for Hira to ensure that every Sprint has an equal workload.
D. They should re-estimate using a more appropriate technique because Story Point estimating intentionally avoids associating time with effort.

Explanation:
The correct answer is A.
If the Developers have estimated work using Planning Poker and story points, the right next step is to use a planning approach that helps Hira understand how much work the teams can realistically complete in a Sprint. This supports forecasting the likely number of Sprints required.
Why A is correct:
It keeps estimation in the same agile framework.
It uses the team’s practical delivery capability to forecast Sprint outcomes.
It avoids false precision while still giving Hira a useful basis for planning.
Why the other options are incorrect:
B is incorrect because converting story points directly into person-days undermines the purpose of relative estimation and can create misleading precision.
C is incorrect because assigning average time allocations to every item is too mechanical and not how AgilePM typically uses story-point-based estimation.
D is incorrect because Planning Poker is already an appropriate technique. There is no need to discard it simply because Hira needs a forecast.
So the best answer is A.

Question#3

HOTSPOT
The Change Manager has mapped stakeholders onto a Power-Interest Matrix, with the aim of identifying suitable actions for managing these stakeholders.

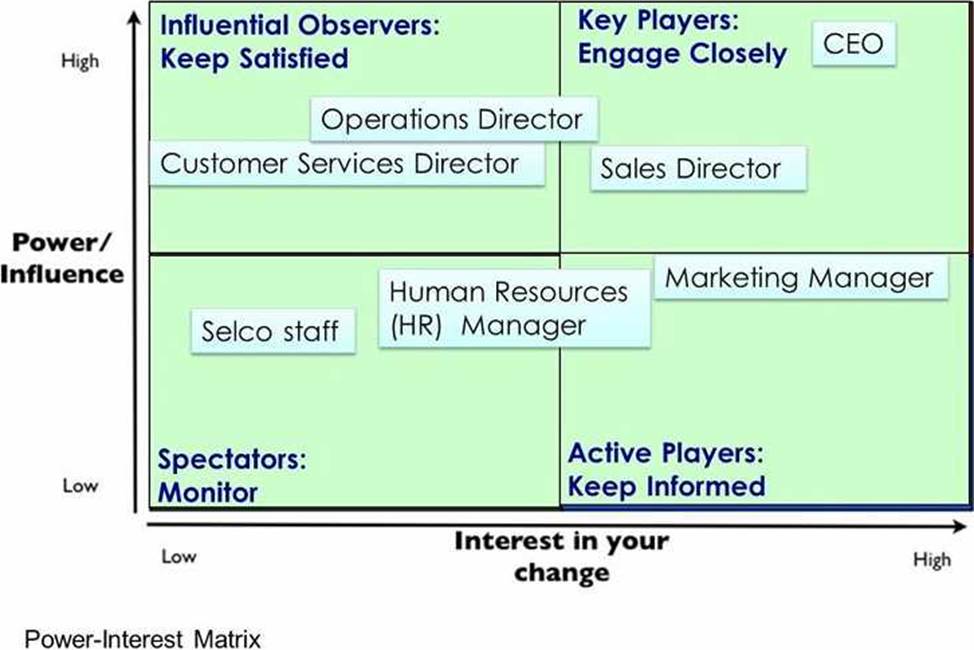

The mapping below shows the current assessment made by the Change Manager.
The 'Interest in your change' axis indicates a combination of the stakeholders' levels of active engagement and their buy-in for the Change Programme.

Using the Scenario and the additional information provided for this question in the Scenario Booklet, answer the following question about Stakeholder mapping and strategy.

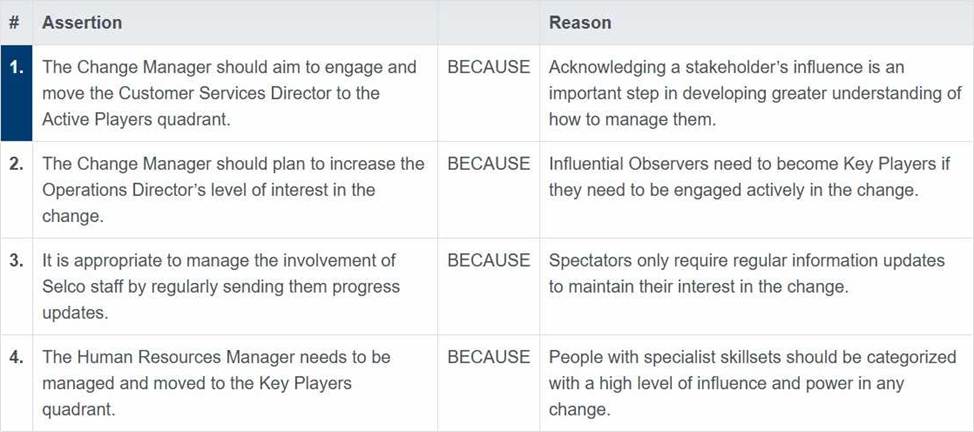

Lines 1 to 4 in the table below consist of an assertion statement and a reason statement.

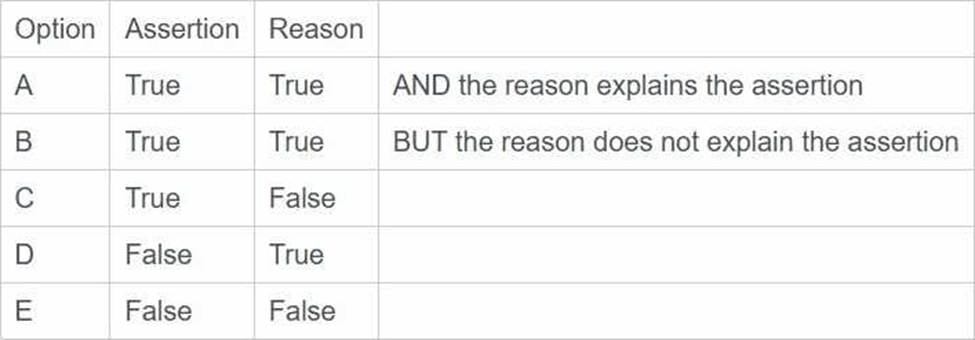

For each line identify the appropriate option, from options A to E, that applies. Each option can be used once, more than once or not at all.

A. Comprehensive and Detailed Step by Step

Question#4

(At the Sprint Review for Sprint 3, it became clear that the Spa infrastructure will not support hydrotherapy treatments. The equipment is unable to chill the plunge pool, making these treatments ineffective.
Demonstrating Agile Leadership and Collaboration, what action should have taken place during the Project Sprint Planning Event to prevent this?)

A. Mira Bachar and Lee Tan should have worked together to integrate stakeholder feedback into the Product Backlogs before the next Sprint.
B. Mira Bachar should have amended the Product Backlogs to include explicit hydrotherapy infrastructure requirements for both Delivery Teams.
C. Hira should have ensured transparency of the Delivery Plan so each Delivery Team could plan the remainder of their Sprints accordingly.
D. Hira should have worked with Sukra Aroon to adjust project timelines to give flexibility to the Infrastructure Team and Treatments Teams before the next Sprint.
E. Sukra Aroon should have documented hydrotherapy infrastructure requirements in the Solution Architecture Definition so the two Delivery Teams were aligned.
F. Sukra Aroon and Mira Bachar should have collaborated to prioritize and communicate hydrotherapy requirements to the Infrastructure Team.
G. Brinda Vyas and Hira should have ensured hydrotherapy treatments were align with business strategy.
H. Brinda Vyas should have worked with the Treatments Team to ensure hydrotherapy-related treatments are feasible within constraints.

Explanation:
The correct answer is F.
This issue happened because there was a failure of cross-team alignment between business intent and technical implementation. The treatments being developed required a specific infrastructure capability, but that dependency was not properly translated into prioritized, shared understanding during planning.
In AgilePM, the most effective way to prevent this is through active collaboration between the business/value role and the solution/technical role. That is exactly what option F describes.
Why F is correct:
Mira Bachar represents the business need and delivery priorities.
Sukra Aroon ensures solution integrity and technical feasibility.
Hydrotherapy is not just a treatment idea; it has infrastructure implications.
Therefore, during Sprint Planning, they should have worked together to make sure those requirements were:
understood,
prioritized,
communicated clearly,
and reflected in the work of the Infrastructure Team.
This is a strong AgilePM answer because it combines:
Agile leadership through collaboration rather than command-and-control,
practical coordination across dependent work,
and shared responsibility for making sure business goals are technically supported.
In this case, the plunge pool chilling capability was a critical enabling requirement. If Sukra and Mira had aligned early, the infrastructure team would have known that hydrotherapy capability was not optional or implicit, but a necessary requirement for the increment to deliver its intended value.
Why the other options are not the best answer:
A. Mira Bachar and Lee Tan should have worked together to integrate stakeholder feedback into the Product Backlogs before the next Sprint.
This is not the best answer because the issue was not mainly stakeholder feedback. It was a missed dependency between treatment design and infrastructure capability.
B. Mira Bachar should have amended the Product Backlogs to include explicit hydrotherapy infrastructure requirements for both Delivery Teams.
This is partly useful, but too one-sided. Mira alone should not be expected to define technically specific infrastructure requirements without collaboration from Sukra. AgilePM encourages joint work between business and technical roles.
C. Hira should have ensured transparency of the Delivery Plan so each Delivery Team could plan the remainder of their Sprints accordingly.
Transparency helps, but this would not by itself guarantee that the chilling requirement was recognized and built into the infrastructure solution.
D. Hira should have worked with Sukra Aroon to adjust project timelines to give flexibility to the Infrastructure Team and Treatments Teams before the next Sprint.
This is reactive and schedule-focused. The real problem was not insufficient time; it was missing alignment on a critical requirement.
E. Sukra Aroon should have documented hydrotherapy infrastructure requirements in the Solution Architecture Definition so the two Delivery Teams were aligned.
Documentation may help, but this is too document-centric for the best AgilePM answer. AgilePM prefers collaborative communication and shared understanding over relying primarily on formal documents.
G. Brinda Vyas and Hira should have ensured hydrotherapy treatments were align with business strategy.
Business strategy alignment is important, but it does not address the specific technical dependency that caused the failure.
H. Brinda Vyas should have worked with the Treatments Team to ensure hydrotherapy-related treatments are feasible within constraints.
This is not the best role fit. Feasibility is primarily a technical and solution concern, supported by the Solution Architect, not mainly the Business Visionary.
AgilePM perspective:
This question is about preventing integration failure across two Delivery Teams. AgilePM would favor:
early identification of dependencies,
collaboration between business and technical roles,
clear communication of enabling requirements,
and planning based on shared understanding of what is needed to deliver business value.
Hydrotherapy treatments only create value if the supporting infrastructure can actually enable them.
So the business priority and the technical solution had to be connected during planning.
Therefore, the best AgilePM answer is F.

Question#5

Midway through Project Increment 4, a joint Sprint Retrospective is held with Developers from both Delivery Teams.
Some members from Marketing and IT, based in India, join via video conferencing.
Issues raised:
. Dependency management challenges
? Concerns about AgilePM principle 'Demonstrate Control'
To address this, Mira Bachar and the Developers invite Hira and Sukra Aroon to help Delivery Teams understand the issues, assess the consequences, and collaborate on solutions that align with AgilePM and Scrum.

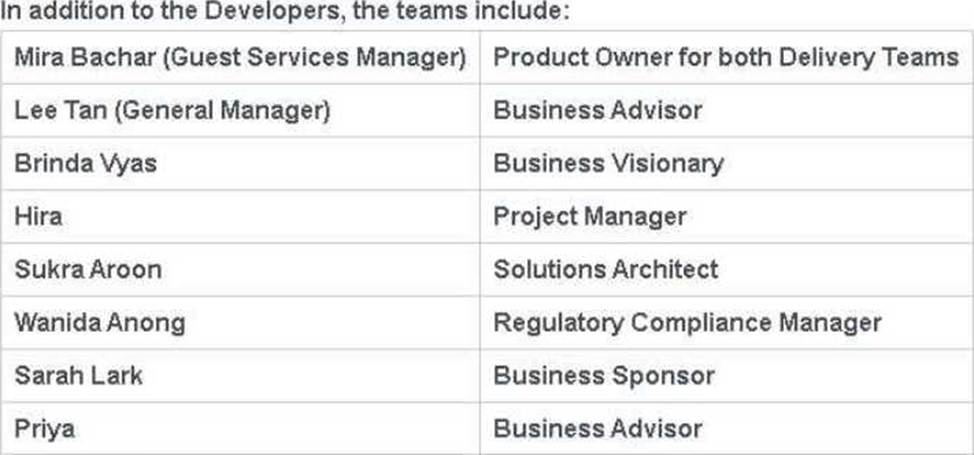

In addition to the Developers, the teams include:

Another of the EPR Eco-spa's commissioned in India experienced major quality issues, causing a three-week shutdown. Stakeholders are now worried about similar problems in Project Increment 4.
Which 2 of the following actions would appropriately reassure stakeholders that the same quality issues will not arise in this project?

A. Engage stakeholders in Sprint Reviews and encourage detailed quality discussions on delivered increments.
B. Define and make visible quality criteria for Backlog items, and ensure the Delivery Teams collectively confirm compliance before declaring 'Done'.
C. Explain to stakeholders that AgilePM prevents quality issues through iterative development, incremental delivery, and continuous improvement.
D. Appoint an independent Quality Manager to approve completed work before it is released.
E. Review the India project's issues with stakeholders and demonstrate how Project Increment 4 addresses them differently.

Explanation:
The best answers are B and E.
B is correct because AgilePM’s strongest reassurance comes from visible, embedded quality control. Making quality criteria explicit and ensuring teams confirm compliance before calling work “Done” shows that quality is being managed proactively, not assumed.
E is also correct because stakeholders are specifically worried due to problems in the India project. Reviewing those past issues and showing how Project Increment 4 is handling them differently directly addresses their concern with evidence and learning.
Why the others are weaker:
A is helpful, but it is more about visibility than about the strongest quality assurance mechanism.
C is too absolute; AgilePM helps manage quality, but it does not guarantee quality issues can never happen.
D introduces a heavier control layer that is not the primary AgilePM approach.
So the correct answers are B, E.

Exam Code: AgilePM Practitioner
Q & A: 189 Q&As         Updated:  Oct 07,2026

 Access Complete AgilePM Practitioner Preparation Material

What This AgilePM Practitioner Study Resource Helps You Do

Review Key Concepts

Review the technologies, products, processes, and practical skills covered by the current AgilePM Practitioner exam objectives.

Practice Scenario-Based Questions

Work through independently developed questions designed to strengthen your understanding of technical scenarios and decision-making.

Identify Knowledge Gaps

Use your results and the provided explanations to find weaker areas and focus your study more effectively.

How to Use This AgilePM Practitioner Preparation Material

Review the Exam Scope

Start by reviewing the topics covered by the AgilePM Practitioner exam. Compare them with the official exam objectives to understand the required technologies, operational tasks, and practical skills, then identify the areas that deserve the most attention.

Practice Independently

Complete a focused set of practice questions for each topic. On your first attempt, avoid referring to notes, answers, or other study resources so that you can evaluate your current understanding more accurately.

Study the Explanations

Review the answers and explanations after completing each practice session. Understand why the correct option is appropriate for the given scenario and why the other options may be incorrect or less suitable.

Close Knowledge Gaps

Keep track of incorrect answers, unfamiliar concepts, and weaker knowledge areas. Review these topics using official documentation and practical experience, then answer the related questions again to reinforce your understanding and monitor your progress.

Independent AgilePM Practitioner Preparation Resource

CertQueen independently develops its certification study materials for educational purposes. The practice questions are not copied from, recalled from, or presented as live or official exam questions.

CertQueen is not affiliated with, endorsed by, sponsored by, or authorized by any certification provider. Certification names, exam codes, product names, and related trademarks are the property of their respective owners and are referenced only for identification and educational purposes.

Exam Code: AgilePM Practitioner
Q & A: 189 Q&As
Updated:  Oct 07,2026

 Access Complete AgilePM Practitioner Preparation Material
